“Focusing on the why behind a mistake breaks the pattern.”
The root cause of all the mistakes new BIM Coordinators make is not technical; it stems from misreading their role’s true responsibilities.

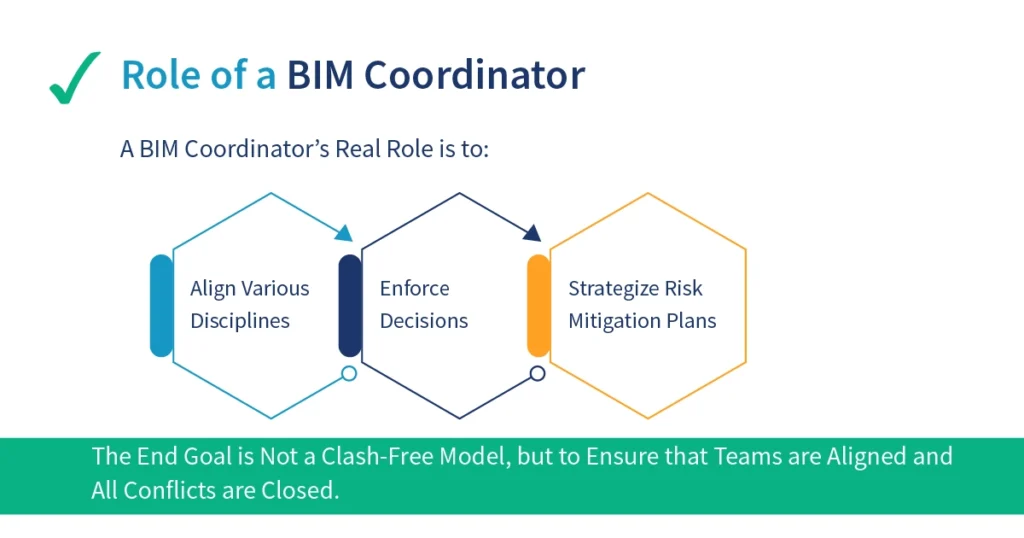

The role of BIM Coordination, in reality, is the act of controlling the project. The primary focus of BIM Coordination is to bridge the coordination gap between design intent and construction execution.
A BIM Coordinator’s role is to ensure that architectural, structural, and MEP systems work together as a system. In modern complex projects where it is impossible for disciplines to work in isolation.

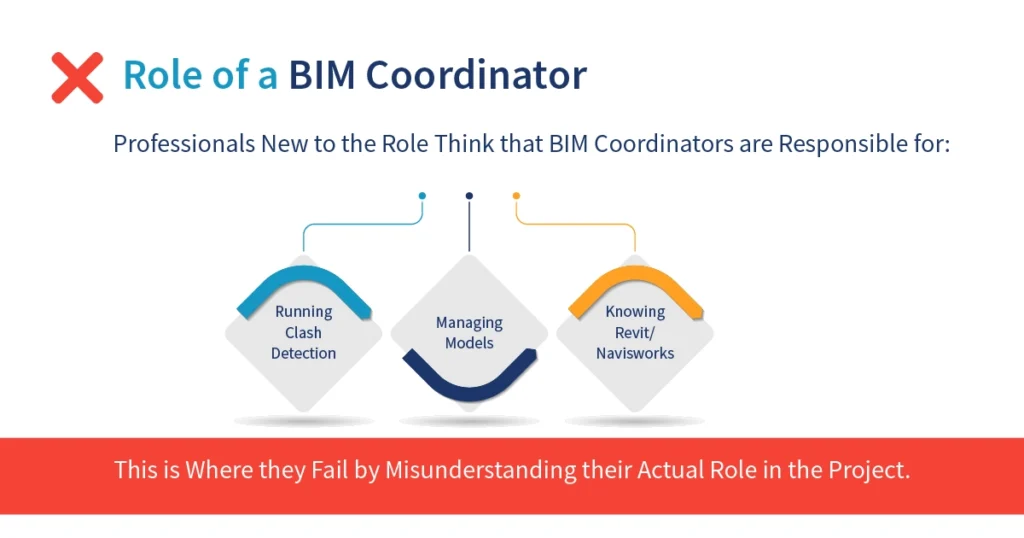

Professionals new to the role think that BIM Coordinators are responsible for:
This is where they fail by misunderstanding their actual role in the project. Hence, they face challenges in construction management, performing daily duties, and staying relevant in the industry.
Emerging professionals must recognize that it is not about the BIM software skills.
The industry demands a BIM Coordinator to align various disciplines, enforce decisions, and strategize risk mitigation plans.
Now, as a BIM coordinator, you too will use Revit, Navisworks, Autodesk Construction Cloud (ACC), etc.
However, your end goal is not a clash-free model, but to ensure that teams are aligned and all conflicts are closed. Under a BIM coordinator’s role, you have to surface model conflicts early, ensure that teams do not postpone clarification meetings, and align design decisions with construction reality.
As a BIM coordinator, you will be dealing with various teams, and your goal is to make them work as a cohesive system.

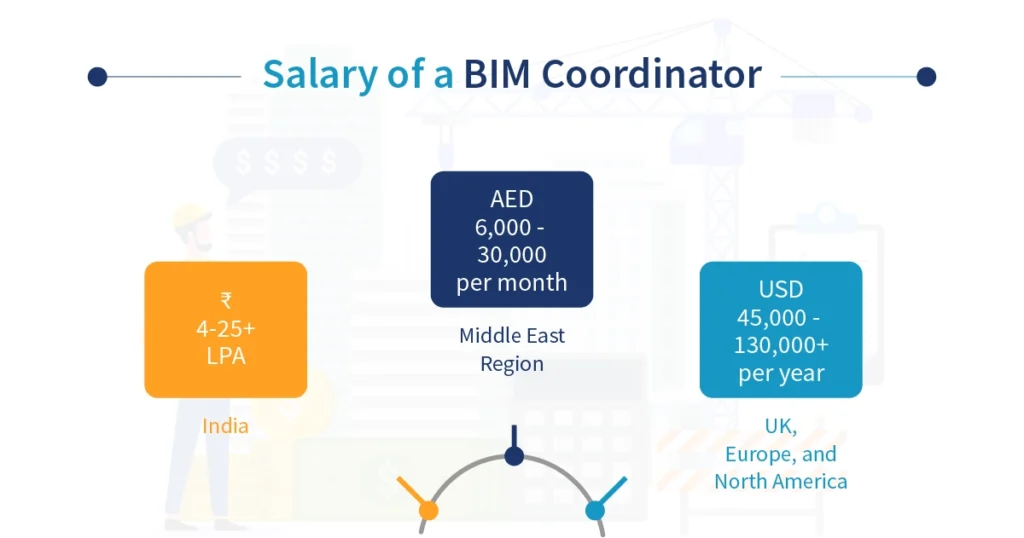

The salary of a BIM coordinator varies based on the various capabilities of a professional.
While initially, the pay scale is based on the model handling and tool proficiency, it gradually changes to:
In India, a BIM coordinator's salary ranges from ₹4-25+ LPA, while in the Middle East region, it ranges from AED 6,000 - AED 30,000 per month. And in the global market, which includes the UK, Europe, and North America, it ranges from USD 45,000 - USD 130,000+ per year.
A good BIM Coordinator (not just in terms of experience) will observe things from the individual perspective of every discipline.
They will have to work with all the disciplines involved in the project, revoke their tendency to prioritize individual team success, and instead work as a system.
For example, an architect will focus on having conceptual clarity and will be more concerned about the spatial logic and aesthetics. They will not think about the complexities downstream during actual construction.
For engineers, their priority lies in being code-compliant, ensuring safety margins, and elevating building performance.
They can oversize systems to fit into the code brackets. When conflicts arise during execution, they become resistant to change, forcing others to change.
This causes ambiguity in execution, delaying project flow, and making construction difficult.
Contractors will see correct geometries as a problem if they interfere with the construction reality and cause delays in installation. They see BIM as a constructability tool, where they demand care on access clearances, lifting paths, and the overall construction sequence.
They experience the real-world site constraints, and their job is to elevate labor productivity and complete daily execution targets.
BIM coordinators deal with all these natural team misalignments. Because every team is individually driven towards its own success.
As a new professional, you should understand that software skills will not work here.
Once you learn to leverage the model, you can force decisions and be a system integrator, not a modeler.
You will have to contain risk upstream by spotting constructability risks earlier, record agreed solutions, and lock decisions at the right time.
Now, as you have the core idea of the BIM coordination process, let’s talk about the silent credibility destroyers.

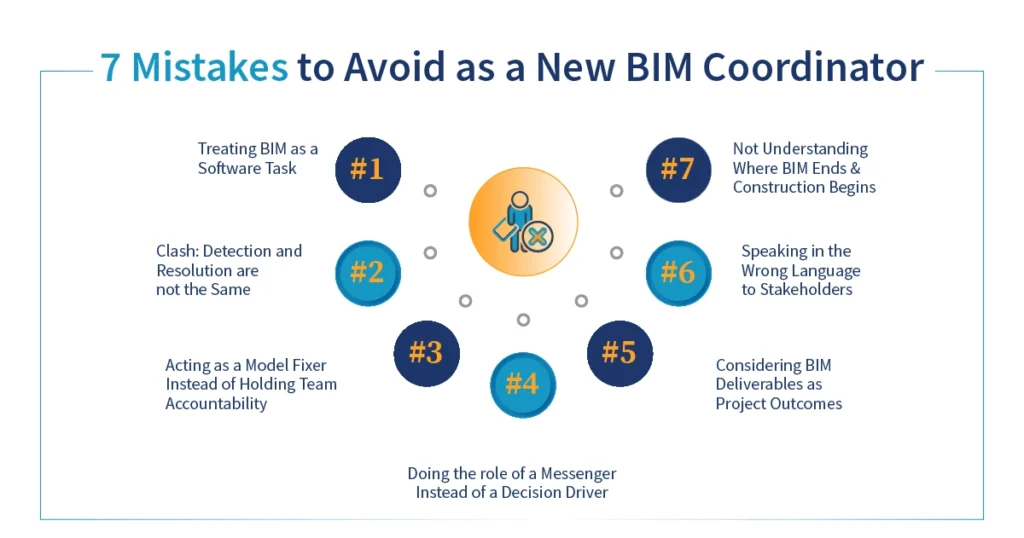

New BIM coordinators think that more activity will improve BIM coordination services. They aim for visual appeal, ultimately ignoring the unresolved conflicts.
What they do feels productive, but it is the wrong way to do the job.
At the end of the day, they are expected to resolve issues that arise during the construction as RFIs, rework, and delays.
On-site, the cleanliness of a model will have zero impact if the systems do not fit seamlessly or the sequence is not realistic.
New BIM Coordinators avoid complex conversations with architects, engineers, and contractors. This is generally a safe move, which feels secure, but slowly destroys their credibility.
So, if you are joining as a BIM Coordinator, you must learn to use the model as a decision platform. You are not there to detect clashes; instead, your role ensures that the clash is resolved on time, not causing any further delays.
Your job is to initiate coordination meetings, to discuss and document approvals for changes to resolved coordination issues with various disciplines. If there is a clash, you are there to find both sides of the issue, communicate, come up with a solution, and fix a deadline.
For example, if a utility component is clashing with an architectural component, you are the person connecting both teams to understand the BIM coordination requirements and resolve it.
As a new coordinator, it is tempting for you to run clash detections to generate weekly clash reports, impressive screenshots (that might convey but don’t resolve), and finally zero cloure.
You need to understand that clashes are not the real problems. Those can be hidden without addressing access issues and sequence conflicts.
BIM coordinators new to the field need to get out of the thought that fewer clashes are equal to good coordination.
The realization point…
Your real job is to find the underlying reason for the clashes.
You might think of categorizing clashes as resolved and unresolved, which most of the new BIM Coordinators will do.
But your take on this, will make the real impact on the project.
When you find a clash, find out the decision maker, what changed, and the risk that was accepted.
Just stay as you are. I am simplifying this for you.
A clash is not a bug that needs to be identified and fixed. But it is a decision to be made and documented.
While dealing with a clash, your first step is to look for the accountable decision maker. New BIM Coordinators are often rebuked with answers like, “the team agreed”, “as discussed”, etc.
Whereas, you should aim for the person’s name, their role, and the discipline they belong to.
Another concern is what risk was accepted to clear that clash. For example, whether the access was reduced or the tolerances were tighter.
This will protect your position as if the risks are unstated, as they cause problems for the BIM Coordinator by resurfacing later during construction.
As a new BIM Coordinator, you will always have to keep things going.
Because initially, your mindset drives you to keep the project going, play it safe. Your actions are not drawn towards clearing conflicts through intense interdisciplinary discussions.
New professionals step back from holding teams or individual members accountable for clashes.
Instead, you fix consultant errors, and the moment you do it, you own it.
So, to avoid your decisions and actions backfiring, you need to learn to work as a “system integrator” and not the fixer.
Most BIM Coordinators who have just entered the market take professionalism in a different way.
While their role demands it, they avoid taking any positions in critical situations and instead pass on messages.
They carefully avoid initiating complex discussions, and end meetings by only noting the issues, but no conclusion.
BIM Coordinators should not wait for someone to take action; instead, they drive decisions to clash resolution and focus on creating BIM execution plans.
You need to initiate and drive the critical situation that other teams are avoiding. This means framing options, mentioning the impacts of each, and fixing deadlines.
Even after doing the above, if a clash persists and has not been resolved despite multiple reminders, your actions are to document and escalate it to your BIM Manager.
The best way forward for new BIM Coordinators, to be a decision driver, is to show the team the consequences and stop arguing opinions.
To be an effective BIM Coordinator, you must learn to differentiate between deliverables and outcomes.
New professionals in the field assume that if the LOD level is met, clash reports are submitted, and drawings are delivered on time, everything is on track.
However, in reality, contractors are concerned about whether the coordinated models reduce RFIs, protect timelines, and prevent rework.
Most BIM Coordinators learn this over time, but if you start practicing this from now, you will have an unfair advantage.
Avoid optimizing the workflow for documentation; instead, focus on execution.
You must ensure that files are not only complete, but are usable on site. A complete BIM model without an install sequence, access clarity, or tolerance strategy is useless in reality.
On-site teams will follow the shop drawings generated from the federated BIM models to install systems. If the issues are not addressed and only the LOD is achieved, BIM processes become an overhead to on-site teams rather than an advantage.
BIM Coordinators often find it difficult to communicate with the various stakeholders.
This is common with new professionals in the field, since they do not understand that there is a different language for each stakeholder in the project team.
What happens is that they might talk about the schedule and project timeline with the architect. Whereas the architect's focus is on design intent and constraints, the project managers are concerned about timelines, and the contractors are concerned about the sequences and various tolerances.
New professionals are not trained with this skill, and this has to be learned over time. However, you can start acquiring this practice by expressing coordination issues in terms of risk, time, cost, and responsibility.
New BIM Coordinators emphasize modeling everything, despite the construction value on-site during the design and construction stages.
They might chase LOD 400+ detailing, but without a procurement plan or vendor finalization. As they have just started, they could not relate to the site variability and tolerances on-site.
What can you do here without prior experience?
That’s the real question, right?
The answer lies in framing your mind into understanding that BIM is a planning and coordination tool. Despite the millimeter-level accuracy that BIM modeling tools offer, on-site construction cannot be precise to that extent.
While executing, working with adherence to the exact dimensions does not happen. Installations have to be done within workable variations.
For instance, concrete might be ±10–20 mm off, and the quality of steel determines whether it can bear the load calculated virtually within the model.
As a BIM Coordinator, if you are ignoring tolerances, the system is technically fit, but problematic to build.
Avoiding the above-mentioned mistakes, you might get dragged into conflicts and intense meetings. However, that will make you a useful, grounded, and reliable BIM Coordinator.
Understanding these will help you reframe your mind and prevent such situations early in your career.
Now, you might be craving a list of dos to be a successful BIM Coordinator. So, here goes the correct practices:
To be a successful BIM Coordinator, you do not work on the model; instead work around it.
Applying this smart move will help you control information flow, enforce decisions, and protect construction from design ambiguity.
For example, when you are a person deciding what needs to be discussed, when and with whom, you are already diverting information flow in the correct direction.
You are not the decision-maker; however, you are the one who controls what data reaches them in BIM projects. Recognized BIM Coordinators filter the noise and then present information to the decision-makers.
They use BIM models not to impress stakeholders, but they use those as leverage for better decisions and judgment throughout the construction process.
With this, let’s end this blog with our final thoughts on the journey of the New BIM Coordinator to a highly acclaimed BIM Coordinator.
New BIM Coordinators need to realize that software skills form the smallest part of BIM management/coordination.
Their actual responsibility goes beyond clicks, drags, and frequent saves.
They need to understand that BIM problems occur from avoiding conflicts, postponing team meetings, and hiding clashes that show up on site.
As a BIM Coordinator, you cannot play it safe; instead, you have to initiate, get involved in complex discussions, and conclude meetings with decisions, not notes.
Must Read
What is Architectural Rendering? Techniques, Tips, and the Best Software
Shaping AEC Landscape with the 5th Global BIM Summit
Vom Konzept zur Erfahrung: BIM, AR, & VR
REVIT Add-in | Text Note Purger
REVIT Add-in | Min-Max Elevation
What is Rebar Modeling? Definition, Purpose & is it necessary?
Table of Contents
