A construction project involves several other sub-services for a successful handover.
The project manager is responsible for ensuring that all the services and resources are available during execution.
However, after all the model-based coordination and constructability review, procurement is the process that precedes.
A real-life aspect without which models would remain in software, and never be a reality. Project managers generally oversee this process.
So, what is procurement in construction industry? It is the process that has to be performed without any excuses. It involves sourcing, acquiring, and managing resources, including the services that we would require.
However, every firm has its own procurement strategy included in the project planning. But before that, let’s have a brief about what procurement means in the construction industry.
In simple words, procurement is the process of selecting and approving construction materials, equipment, and services.
The first two refer to all the fundamental materials, from structural beams to slabs and material finishes for the interior.
Now, when I say services, it means all the related services that facilitate smooth construction and project delivery. These services might include shop drawing generation, prefabrication, or laser scanning for site surveys.
Construction project owners generally outsource these services along with critical procurement materials. And procurement must be planned carefully after auditing the construction requirements through model environments.
Dedicated procurement teams handle the above part, along with mitigating risks coming from resource availability cost fluctuations and project changes.
So, as we have got the idea of what procurement is in construction, let’s have a look at the different types.

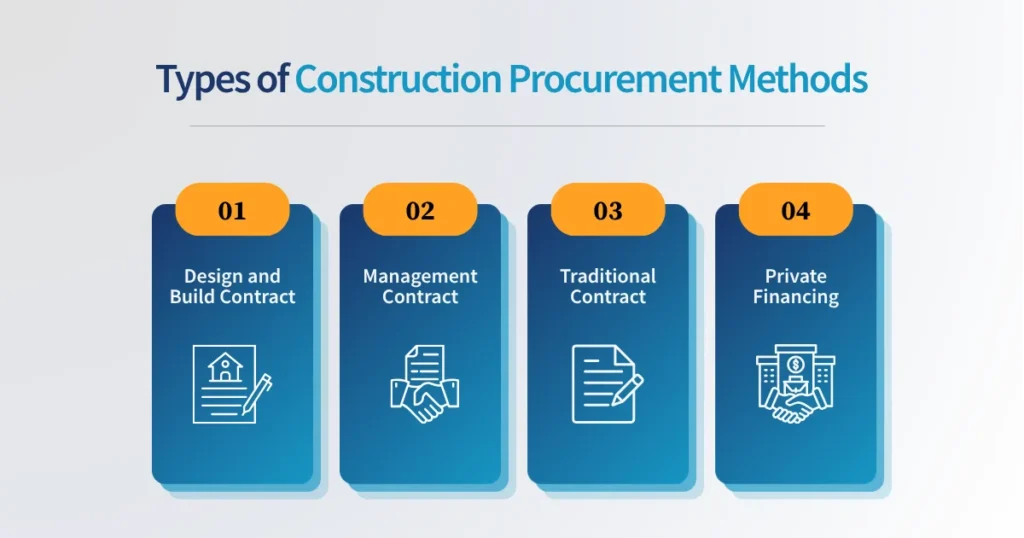

Given the diversity of the industry itself, there are several types of procurement methods unlike the traditional procurement method. And finding the perfect fit is what makes the process tricky, but also interesting and rewarding. Before choosing any plan, it is crucial to understand the project’s business plan.
Here are the most common types of procurement methods and contracts:
In this type of contract, the contractor is appointed for both the design and construction phases. Professionals create a single contract, and the contractor holds the responsibility to handle procurement till project delivery.
Modern construction projects usually prefer this in two ways: one is a single-stage tender, where the contractor issues a lump sum cost first. If the owner sees a reasonable estimate, and it aligns with the project budget, the deal is fixed.
Another is the two-stage tender, where the contractor presents their capabilities. These include programs, preliminaries, project team, overheads, and profits. Once the project team vets this, they appoint the contractor on a consultancy basis, after price negotiation.
Under a management contract, there is a construction manager firm that appoints other subcontractors. And in here, the procurement contractor also exists, with fees fixed as percentages among others. The job of this contractor comes once the other contractor in the design and validation stage completes their work.
This is the most common way for procurement activities using the design-bid-build method. Here, the bidding process comes in between the design and construction phases.
So the contract for procurement is made once the design is completed and competitively bid. The procurement contractor can issue a lump sum contract, taking responsibility for the entire procurement and monitoring of materials during construction.
If the project acquires a contractor that can fund the construction and also have design and engineering expertise, it is this. Here, the client will get the project on lease, and the contractor, since it funded the project, handles the design, build, and operations.
Now, these being the various types of procurement methods, we also have to understand the responsibilities. The set of default tasks, and which tasks might be optional in certain situations; if a contractor has such deep knowledge, then procurement rewards.
In modern construction projects, there are dedicated teams for procurement. And then there is the head, called the procurement manager.
This is the person overseeing the complete procurement activities, including coordinating with quantity takeoff teams. A procurement manager ensures that every purchase is made within time and budget. Professionals with model knowledge can also optimize material lists to offer better cost-effectiveness.
Procurement managers also have to deal with bids and construction RFPs. It is because they are the only ones with the complete cost information of the project.
More accurately, they can provide detailed inputs on building materials, their quantities, and associated costs.
And these are required for drafting proposals in the early evaluation phase of the construction procurement plan. Experienced procurement managers understand the cruciality of this phase. They add extra time to ensure every requirement is listed and quantified for the contractors to prepare detailed estimates.
Procurement managers have this critical responsibility, and truly, their efforts directly impact construction quality. They coordinate with suppliers to get material deliveries on time,
Further, they also have to determine storage spaces at the jobsite, so materials are handy to on-site teams. Alongside this, it is also under their responsibility to keep the materials secure from damage or theft. For this, they have to coordinate with security teams as well.
Another high-priority task in this category is to schedule procurement in coordination with the construction schedule.
The job of a procurement manager starts before the process itself. Apart from procuring materials and services, they also manage and track change orders. They monitor the complete project performance to flag material wastages and find opportunities for optimization. If there are changes in design, the procurement data also needs to be updated. Procurement managers, therefore, ensure that elements and key assets meet the project specifications before procurement starts.
As we were talking about design changes, this brings us to the design team’s role in procurement.
The design team builds the foundation, and the accuracy of their work impacts the procurement process.
It is this team that designs the 3D model of the structure and adds detailed project specifications.
During the design phase, professionals generate detailed drawings that define the material requirements. And not only that, but it also specifies the particular services required during the construction process.
From here on, the procurement team identifies the necessary materials and proceeds with further collaboration.

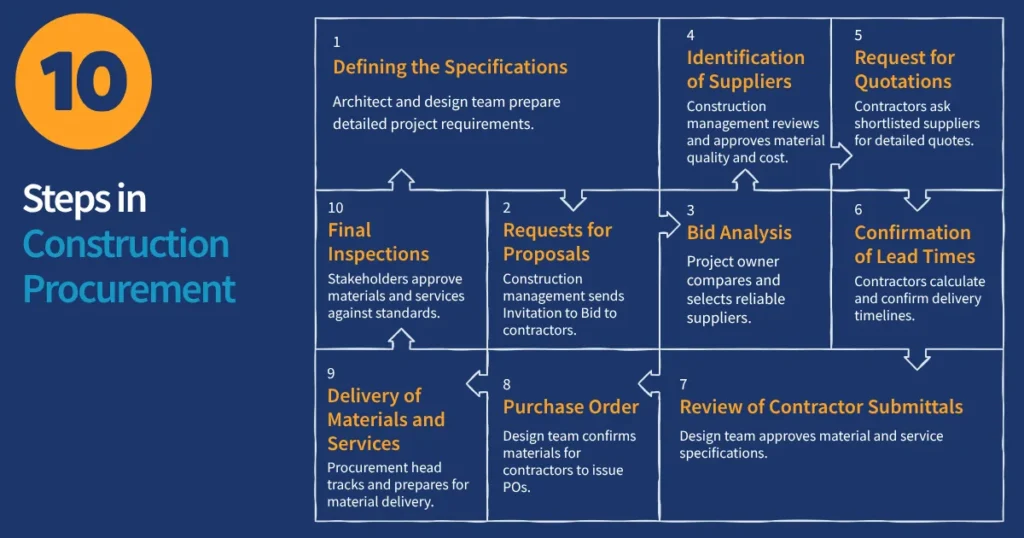

Now, let’s look at the steps a typical construction procurement goes through.
Here will go through the default stages through which the procurement happens. Depending upon the project requirements, firms may restructure these steps.
In construction, precision is paramount to every project-related action. Similarly, here the projects needing procurement must have precise specifications and bidding details.
It sets the fundamental stage for procurement, and usually, the architect and design team prepare the document. The document includes defined material specifications and is prepared in the design phase itself.
This reduces unwanted costs and construction delays and provides contractors with enough time to find and acquire quality materials.
Once the construction management has finalized the documents, the preceding step is to issue an Invitation to Bid (ITB).
This depends upon the project requirement, which type of bid the owner asks the contractor. They further contract the subcontractors for an estimate. For every service or trade, there are separate subcontractors.
They use the document from the design team to find project requirements and obtain price quotes.
Now, two critical phases are complete: the design phase and the bid-receiving phase.
Once the project owner has the bids, they compare and select reliable suppliers. After agreeing on the terms, they sign the contract and the project gradually progresses.
One thing contractors take care of in the process is to create an escalation clause. This is because material and equipment prices fluctuate. And as a result, if the project cost increases, the owner takes the responsibility.
Now, on the contractor’s end, after negotiating contracts and fixing the deal, they make smaller contracts with specialty contractors. In some cases, it may also happen that the project owner starts the procurement process before even signing a contract.
Now the role of the construction management team is to review and approve material quality and cost. The suppliers, after receiving the list, also provide bids to contractors.
The contractor compares prices for the project to get the best value and quality. After finally selecting the right bids, there are a couple of factors to consider.
These are the availability, sustainability, and the vendor’s experience with the materials and services. Most contractors already have a list of contractors from whom they source materials. If a project has any new requirements, then they usually go through the above process.
Or else, they might order standard items like plumbing and lumber from trusted suppliers.
The contractor goes through the above analysis and selects the possible vendors.
These are the general contractors, who now request RFQ from shortlisted suppliers and service providers. The RFQ is a document with detailed information that the suppliers or vendors require to submit quotes.
The document also specifies terms and conditions that bind the contractors to continue a smooth supply. It protects the project from getting delayed due to material shortages.
Lead Time refers to a crucial time segment, which falls between the supplier sending the product and the client receiving it.
Calculating the lead time is a matter of simple addition.
Contactors add the days required to receive the materials, manufacture products, or the availability of services.
This time is a very crucial piece of data that procurement managers use during planning. It gives vital data on which they plan the entire procurement, keeping a check on items that have long lead times.
Now, once again, the ball goes to the design team.
This is the phase where suppliers and vendors have sent their quotes, and they are confirmed.
The material and service specifications once again go to the design team for final approval. And this is because, till now, nothing has been constructed. The 3D design model is the ultimate source of truth for all the material and service requirements.
There are detailed specifications about color shades, material finishes, and sizes. Several firms try to skip this step, or do not put in much effort.
This often leads to missing out on a couple of materials in complex projects. However, when the details are given in writing, tracking and referencing become easy. However, the time is limited, and to prevent unnecessary challenges, this approach is the best.
So the design team approves the list of materials and confirms it for the general contractors to issue purchase orders.
Note that if a project requires fabrication items that also fall under the list.
So, the purchase order for the supplier means to organize and send the product. And for the prefabricators, they will start the fabrication process.
This phase is not a simple one, as it is different from just receiving the products.
Once the shipping begins, the procurement head tracks the product organization and prepares the site to receive the products.
Often, construction sites also have space constraints, which means the space is not ready for the products. The general contractors have to verify the materials and also ensure on-time arrival.
Another important factor is whether the suppliers have packed materials in a way that offloading and unpacking are smooth.
Contractors are also responsible for arranging specialized equipment for unloading and handling delivered materials.
The completion of the above step brings us to the last phase of final inspections. Here, all the involved stakeholders, notably the project owner, designers, and local authorities, approve the materials and services. They ensure that those meet the required quality standards and local building regulations.

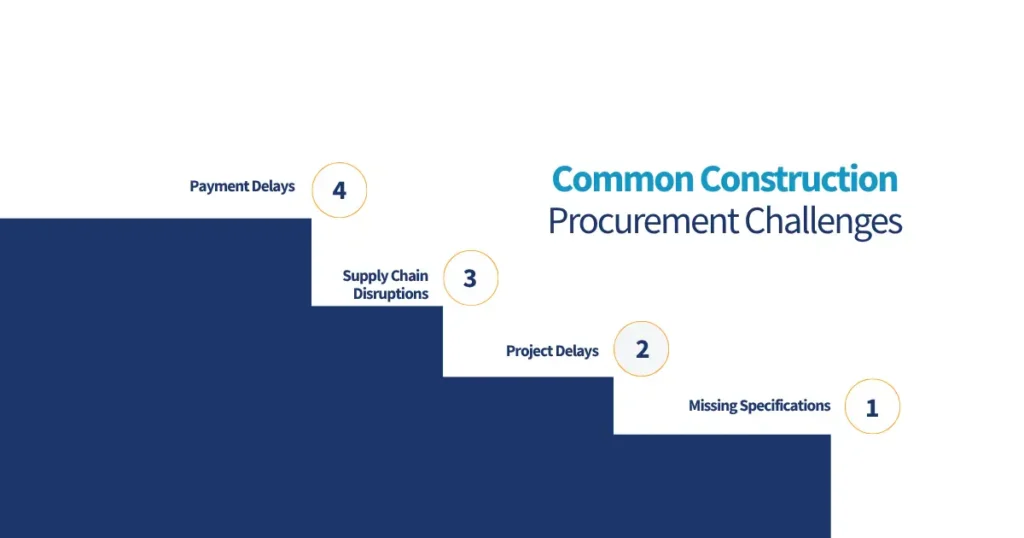

Now, during the above step-by-step process, there are a couple of challenges that procurement managers face.
In most modern construction projects, complexity is in-built. Therefore, things rarely go as per the approved plan. Even after eliminating all the potential causes, construction projects are never out of surprises. Here are some of the common challenges in procurement.
The document we were talking about, which designers prepare in the design phase, can cause conflicts. Even after ensuring all the specifications are correct, there is always some data that is missing. And there, if a key specification is left out, the procurement process fails to meet the project requirements.
Project delays also impact the procurement strategy heavily.
For any reason, if the construction work gets delayed, it changes the construction schedule. And as we know, the procurement team schedules all the activities based on the project schedule.
Therefore, in such cases, the procurement team has to realign dates with the vendors and suppliers. This process causes conflicts in the budget and further impacts material availability on time.
These are one of the most common challenges every construction project faces.
Factors such as weather, material shortages, and labor issues can cause disruptions at any point in time. Supply chain hiccups are bound to occur; however, a procurement management system will ensure that those do not impact construction.
Sometimes miscommunications between contractors and project stakeholders result in late payments.
Inconsistencies in the procurement data generally lead to such issues. And because of inconsistent payment, the suppliers discontinued shipments.
Also, this causes a downfall in the reputation. So, during shortages, the suppliers do not prioritize these contractors. To avoid this, the way forward is to ensure that all stakeholders, contractors, and subcontractors are aligned.
So, these are the common challenges that surface during procurement processes. However, proper prioritization of items with long lead times can reduce the impact.
Regular payment to suppliers/vendors, along with transparency for invoice verification, keeps an overall efficient procurement process.

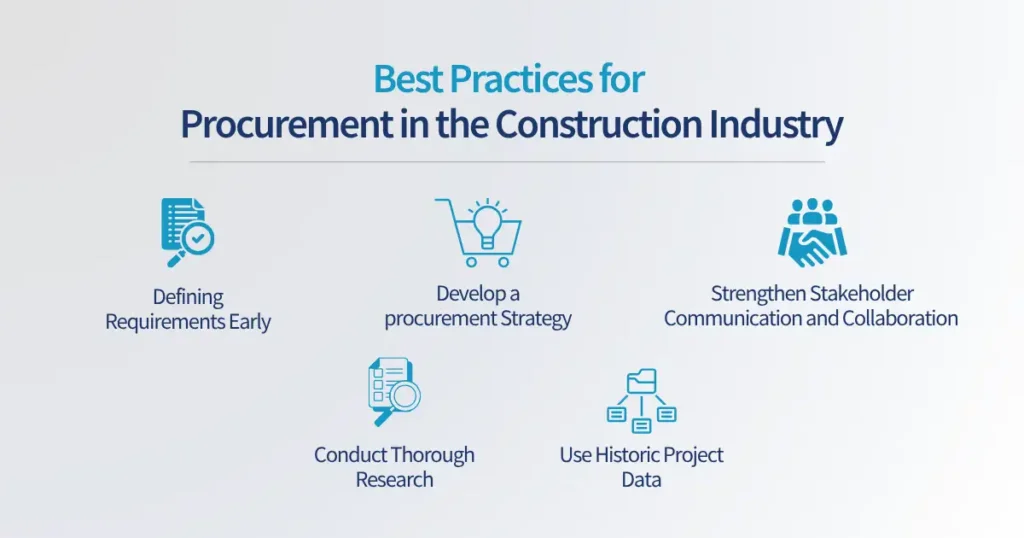

This brings us to the next and final question: what are some of the best procurement practices?
Often, it happens that the procurement manager waits for an approved requirement document from the owner.
This creates confusion among the procurement team and other stakeholders before construction begins.
Since, procurement teams are also part of the project, it is best to intervene in the very first stage itself.
The procurement manager should drive this by aligning with the owner, design team, and other key stakeholders. After all, these stakeholders prepare the document for the procurement team. So, while listing down the project requirements, it is best for the procurement manager to stay in the process.
The construction procurement manager can give their input from the very first stage.
The approach seems simple, but it benefits the project by reducing ambiguity and avoiding over- or under-purchasing.
Every project is different and comes with a set of unique procurement requirements. Using the same strategy for every project leaves the procurement teams with unexpected issues.
Therefore, to avoid those, a suitable construction project procurement strategy is required. This strategy will align with the project’s scope, budget, schedule, risk profile, and delivery requirements.
Upon considering these factors individually, a procurement manager can step into creating a strategy. We can also call this a procurement approach; each adjustment is made to benefit the project, not the other way round.
Transparent communication is a critical aspect of the entire procurement process. The sourcing of materials and services for the entire construction process is something in which every stakeholder has an interest.
For example, the owner wants to make sure that construction runs smoothly, the contractors worry about their deadlines, etc.
However, everything depends on the procurement; hence, the above parties get involved. And here is where clear communication between them heavily matters. It helps resolve misunderstandings, identify challenges early, and schedule procurement activities as per the project timeline.
Procurement managers should have updated information about market prices. This will help them understand whether there will be material shortages or any supply risks.
It is like having market intelligence, so as to anticipate challenges early and make informed decisions.
If you are a general contractor, you will run multiple projects together.
And the historical project data will help them understand the supplier profile.
Now your procurement team can evaluate their performance and procurement timelines to decide. The historical project data saves a lot of time with supplier performance data. Based on it, procurement teams can improve their future project management.
These are some of the best practices for procurement in construction industry.
A thoughtful procurement strategy is one of the key factors for smooth project delivery.
To advance integrated project delivery further, Pinnacle optimizes the entire workflow.
It brings the procurement data and the on-site construction data in a single platform. It provides detailed information about the amount of work completed, the materials consumed, and the stock health.
This approach helps you gain a preventative advantage over the conflicts ahead. With detailed insights, procurement teams can identify high or unnecessary spending. The end goal of every procurement team is to optimize the requirements and save costs.
Must Read
What is Construction Risk Management? Practical Guide for Contractors to Reduce & Mitigate Risk
Mastering Construction Planning: Essential Steps for Project Success
How BIM-Enabled BOQs Save 15% on Complex Construction Projects
Construction Quantity Tracking to Improve Project Monitoring and Control
Quantity Takeoff Services in Construction
MEP Estimation Services: 7 Costly Estimation Mistakes That Can Derail a Construction Project
We have received your submission and our team will contact you soon.
Table of Contents
